Construction Staging Design
UPDATE: Walker Road will be closed between 174th Terrance and Cambray Steet Aug. 3-Dec. 1.

Walker Road will be improved between 173rd and 185th avenues. The map below shows the expected stages of construction. Please note, all dates are estimates and subject to change.
- Willow Creek Culvert Replacement and road closure: August-December 2026 (green, east side of the project)
- North side of Walker Road between 178th and 183rd avenues: November 2026-June 2027 (lavender)
- South side of Walker Rod between 178th and 183rd avenues: July 2027-February 2028 (orange)
- Walker Road full-depth reconstruction: March 2028 (blue)
- City of Beaverton waterline installation: October-November 2026 and July 2027-February 2028
- Tualatin Valley Water District waterline installation: October-November 2026 and July-October 2027
- Final paving and striping: March-June 2028
Download pdf
Typical Cross Section

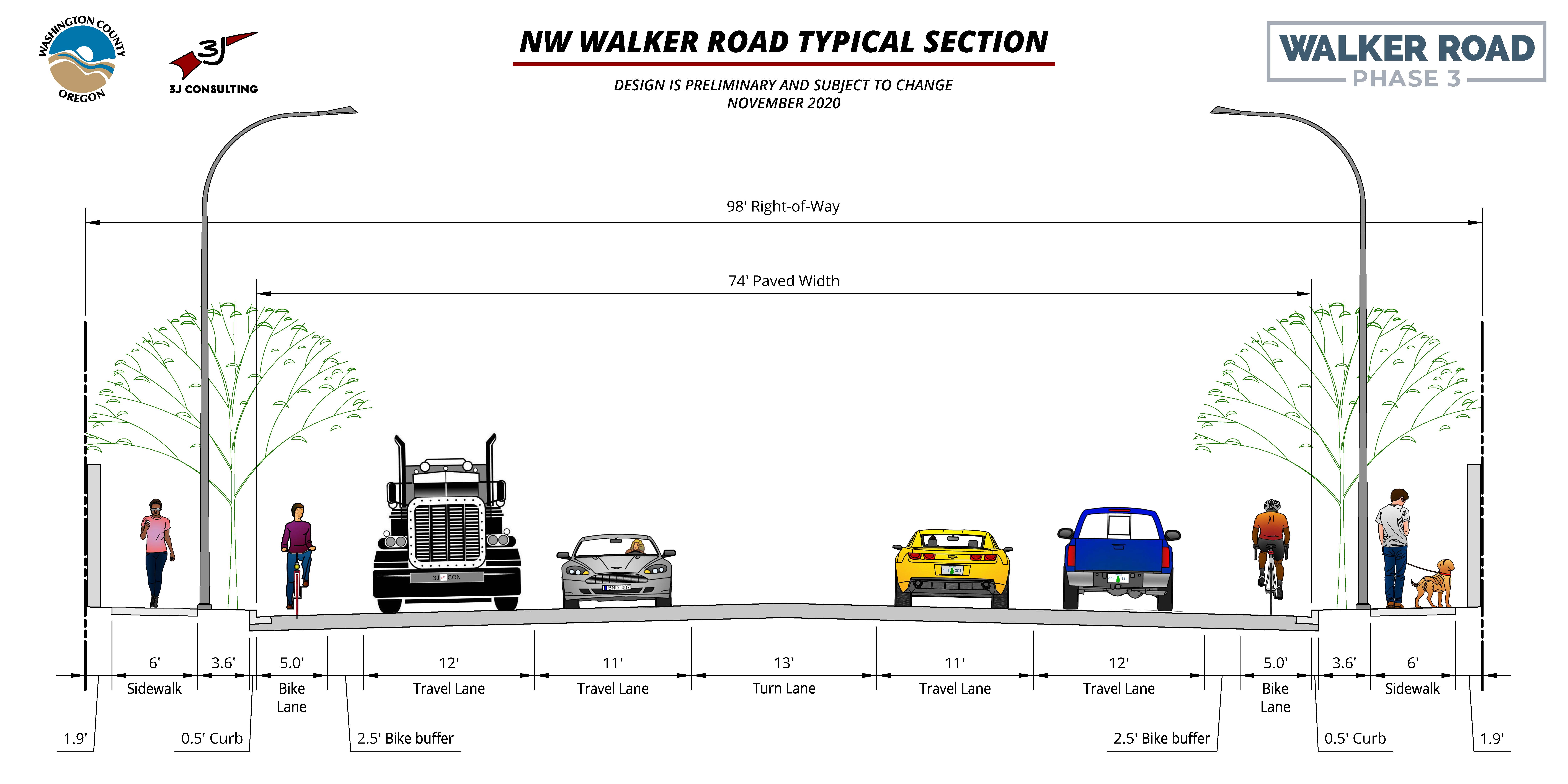

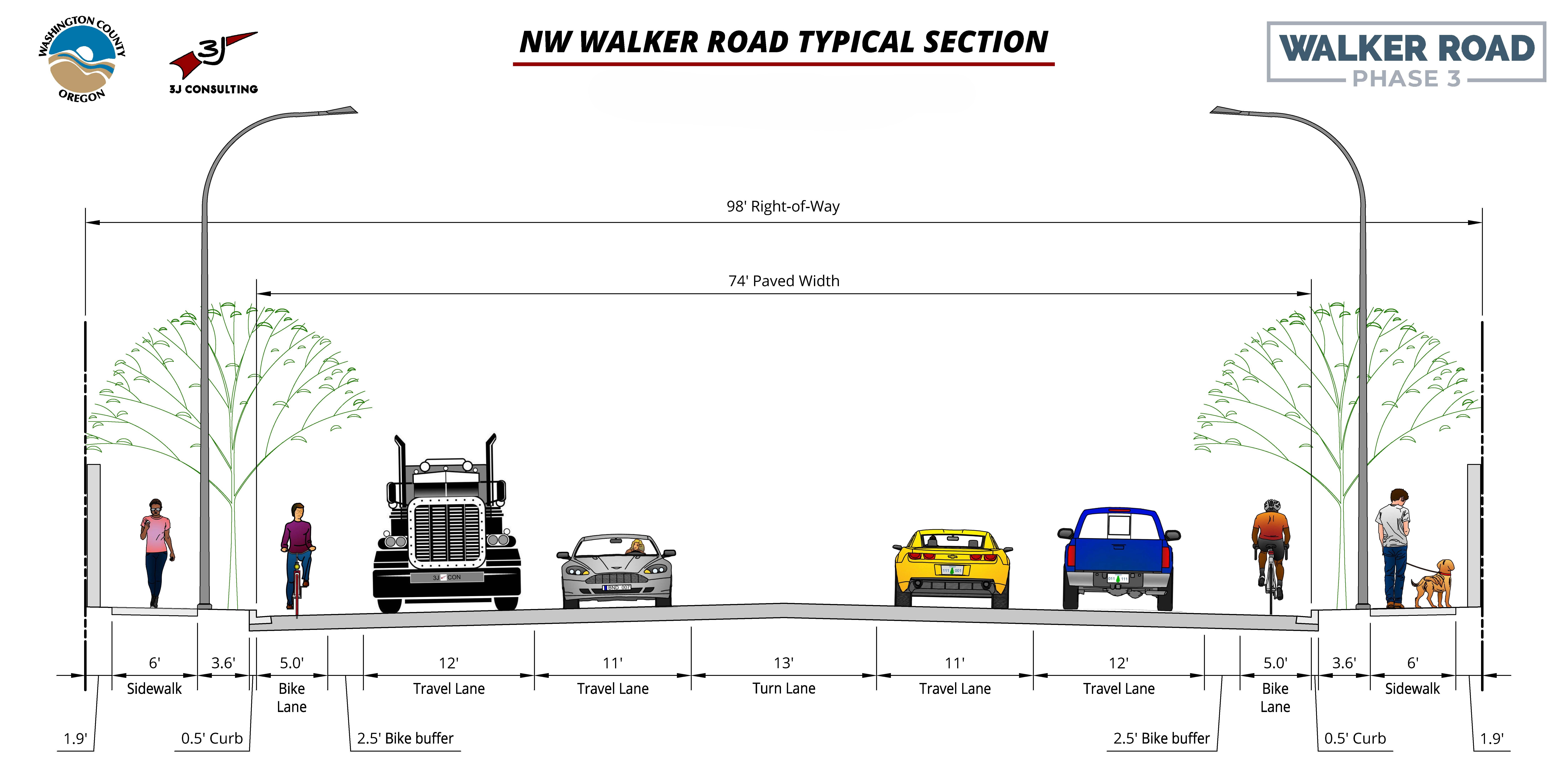

The project cross section shows:
- 6 foot wide sidewalks with a 4 foot curb and landscaping strip
- 5 foot wide bike lanes, buffered with a 2.5 foot buffer
- 11-12 foot wide travel lanes
- 13 foot wide center turn lane
